Why Do Medical Equipment Orders Always Miss Deadlines Even When You Confirm Lead Time Upfront?

zhaikevip@gmail.com 17 min read

Why Do Medical Equipment Orders Always Miss Deadlines Even When You Confirm Lead Time Upfront?

I still remember the surgical gown manufacturer who called me in week six, frustrated that their order was not shipped. They had confirmed a four-week lead time in our quote. What they did not realize was that lead time clock had not even started yet because their packaging spec approval came three weeks after sample approval. This was not our mistake or theirs. It was a structural misunderstanding that happens when buyers treat MOQ, lead time, and packaging as three separate line items in a purchase order instead of three interconnected variables in one production constraint system.

For medical-grade CNC cutting equipment, MOQ, lead time, and packaging are not independent parameters. They form a single production constraint system where changing one variable automatically resets the other two. Most project delays happen because procurement teams confirm lead time before finalizing packaging specifications and minimum order quantities, which creates a timeline gap that neither side anticipated.

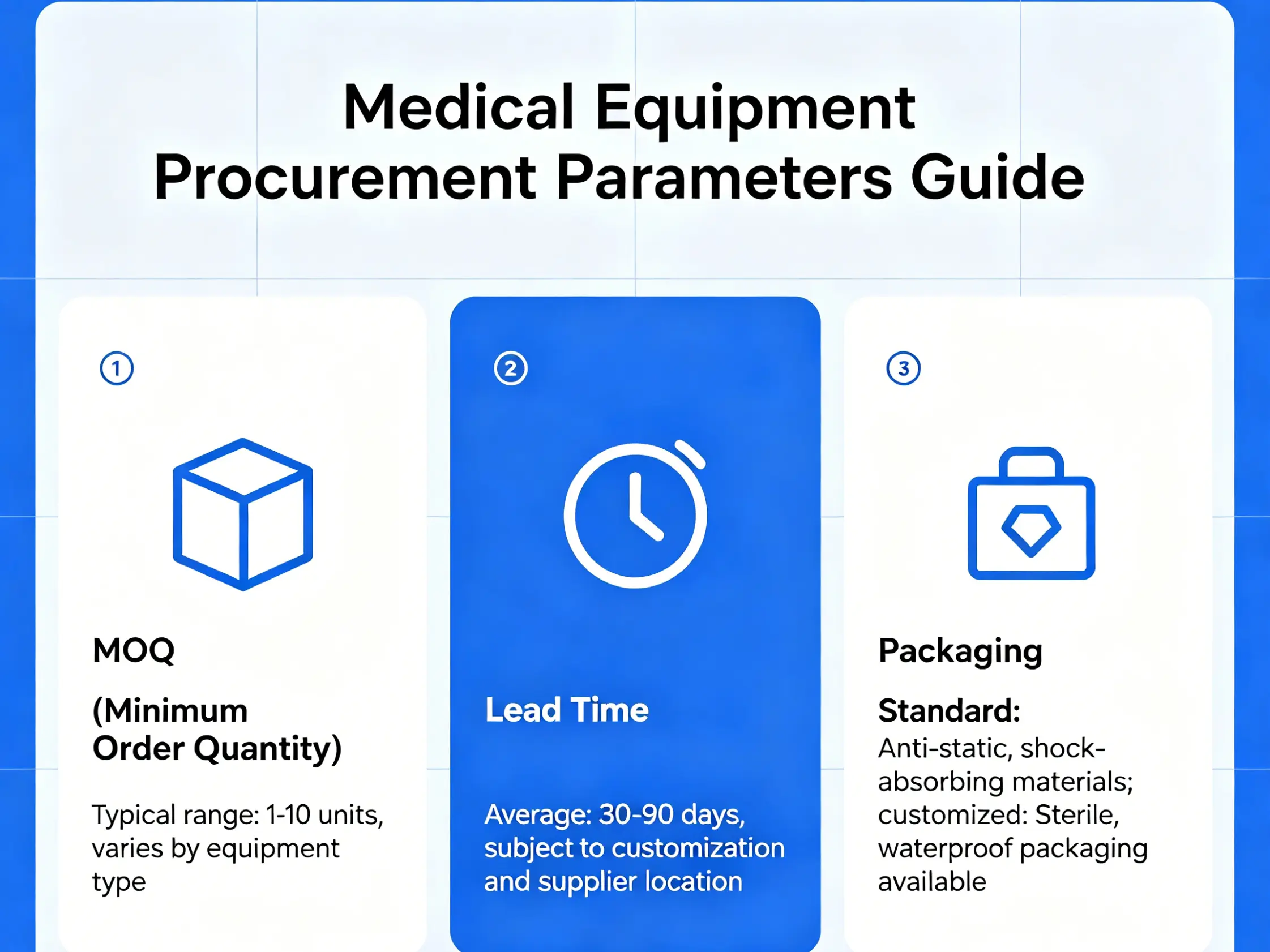

Understanding medical equipment procurement parameters

If you are sourcing CNC cutting machines for medical material processing, you need to understand how these three parameters interact on the production floor, not just how they appear in the quotation spreadsheet. Let me walk you through what actually happens when you place an order.

Why Does Medical-Grade MOQ Start at Higher Quantities Than Standard Industrial Orders?

Most buyers interpret high MOQ as a supplier policy designed to maximize profit per order. That interpretation misses the production floor reality. When we set up for medical-grade material cutting, we are not just switching out cutting blades or adjusting belt speed.

Medical-grade equipment setup requires cleanroom environment activation, certified material handling protocols, and sterilization-compliant packaging preparation[^1]. These setup costs are fixed overhead that must be absorbed across all units in that production run. Lower unit counts simply make per-unit cost unrealistic for both supplier and buyer.

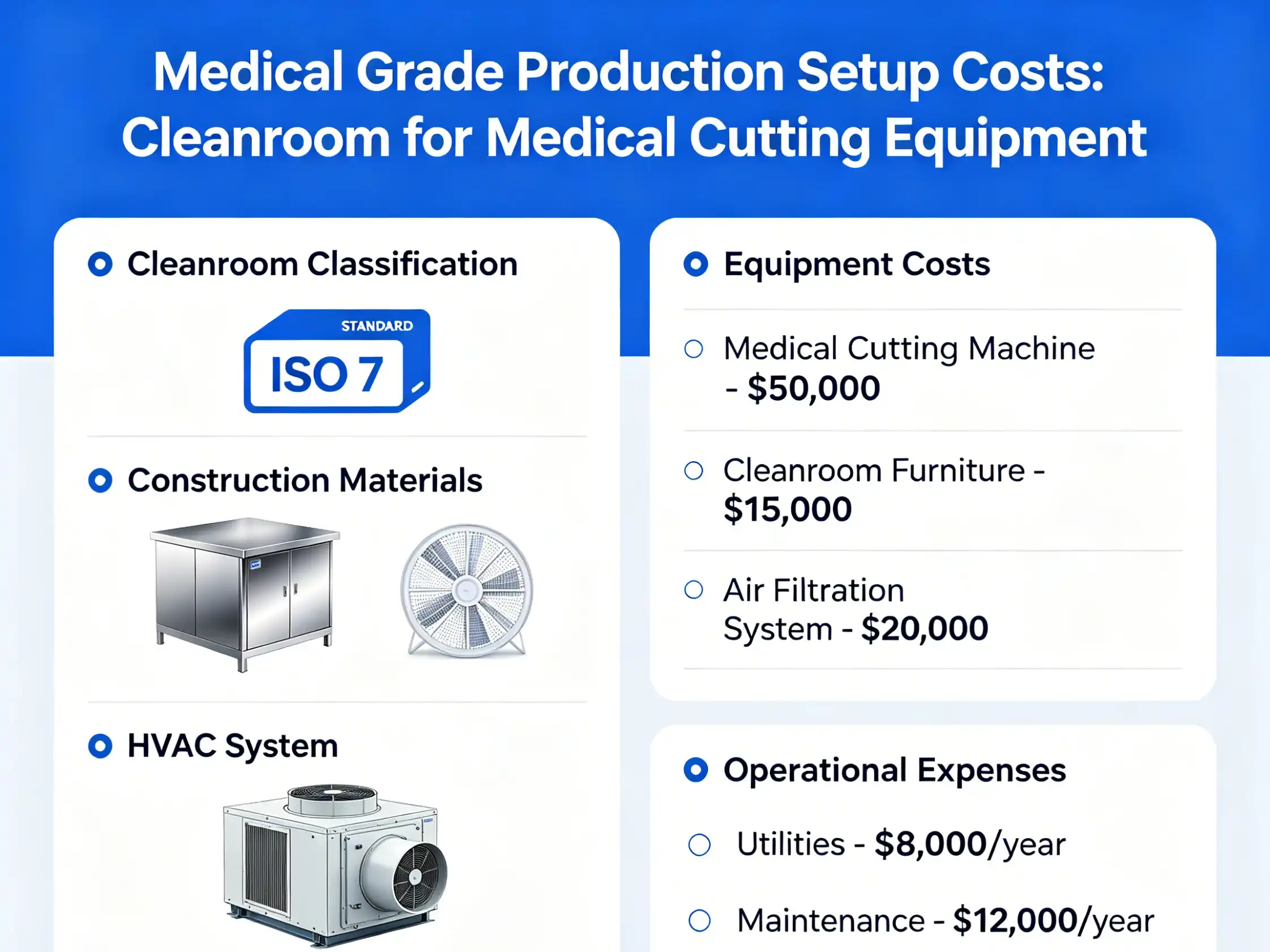

Medical grade production setup costs

What Actually Drives Medical MOQ Numbers

The MOQ you see in a quote reflects three underlying cost structures that do not scale linearly. First, cleanroom environment preparation is a binary cost. Either you activate the controlled environment or you do not. There is no partial activation for smaller orders. This typically locks in 8-12 hours of preparation time before the first unit enters production.

Second, material certification documentation requires batch-level traceability[^2]. Each production run generates compliance paperwork that tracks material origin, handling procedures, and quality checkpoints. This documentation workload is identical whether you produce 50 units or 500 units. The administrative cost per unit drops dramatically as order quantity increases.

Third, post-production sterilization packaging setup involves tooling configuration that cannot be partially deployed. Sterile pouch sealing machines, certification-compliant labeling systems, and tamper-evident packaging equipment all require full setup cycles regardless of order size.

Cost Component Fixed or Variable Impact on MOQ
Cleanroom activation Fixed (8-12 hours) High for orders under 100 units
Certification documentation Fixed per batch Decreases proportionally with quantity
Packaging equipment setup Fixed per configuration Adds 15-20% cost for orders under 50 units
Material handling protocols Variable but step-function Triggers new cost tier below certain quantities

When a protective equipment manufacturer requests a 30-unit trial order, they often interpret our 100-unit MOQ counteroffer as negotiation tactics. What they do not see is that producing 30 units at economically viable pricing would require us to charge nearly three times the per-unit cost shown in standard quotations. The MOQ is not arbitrary. It is the break-even point where setup costs become absorbable within normal pricing structure.

Some buyers try to bypass MOQ by requesting mixed configurations in a single order. This approach usually backfires because each configuration requires separate setup cycles. A 100-unit order split across three different blade configurations effectively becomes three separate 33-unit orders from a production cost perspective, which brings per-unit cost back above viable thresholds.

Why Does Lead Time Reset When You Change Packaging Specifications?

The most common timeline disconnect happens when buyers approve equipment samples but later submit detailed packaging requirements. They assume packaging is a final-step wrapper that does not affect production schedule. This assumption collapses when medical-grade packaging intersects with certification requirements.

Standard lead time quotes assume standard industrial packaging: foam inserts, cardboard boxes, and basic moisture protection. Medical-grade packaging requires sterile pouches, certification-compliant sealing, tamper-evident features[^3], and often involves a completely separate sampling and approval cycle that adds 10-15 days before production can begin.

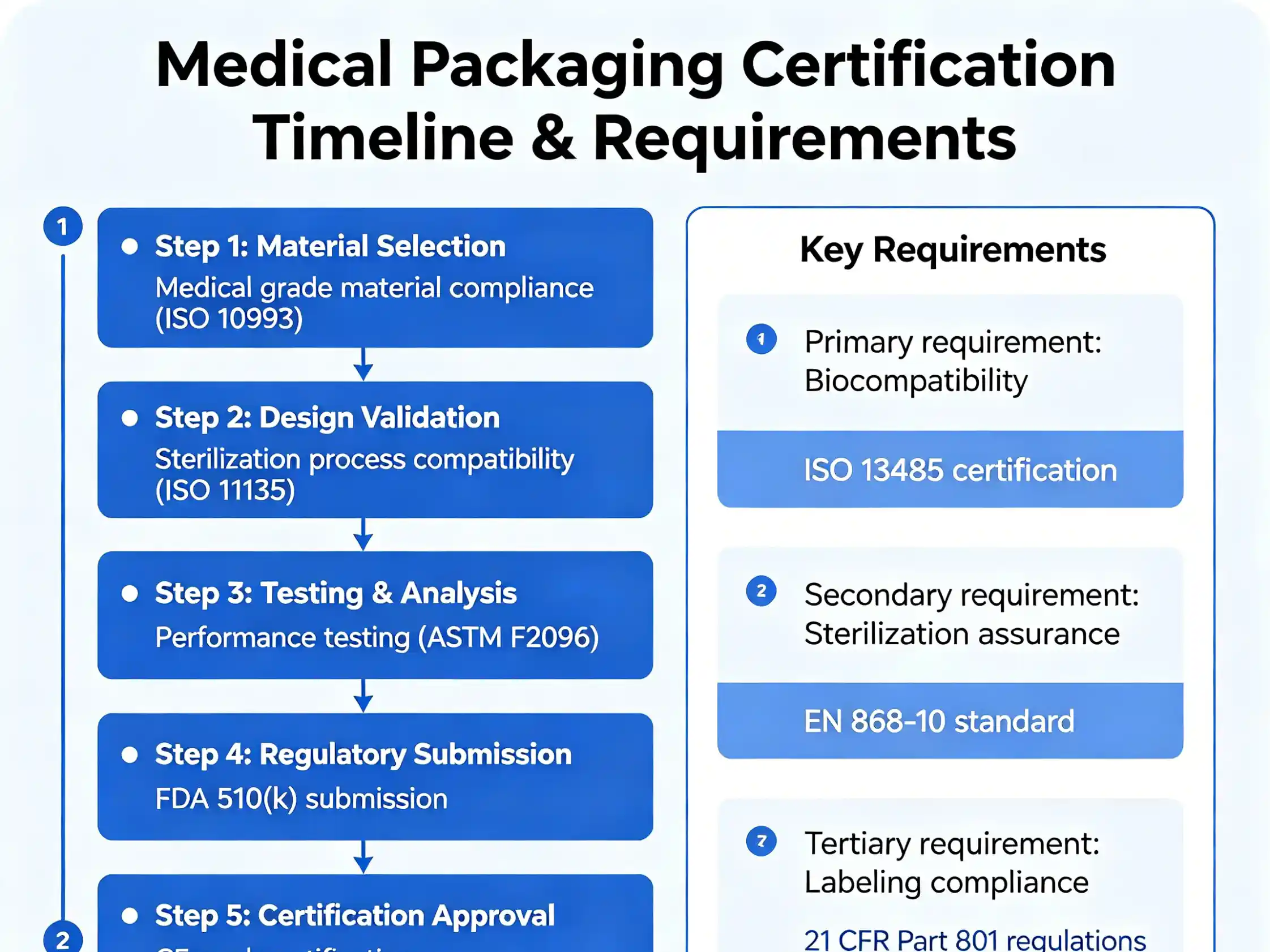

Medical packaging certification timeline

When Packaging Becomes a Production Constraint

I worked with a medical device manufacturer who approved equipment samples in week two, then submitted their packaging specification sheet in week four. Their spec required individual sterile pouches with heat-sealed edges, certification labels with batch traceability codes, and outer cartons with tamper-evident tape. Each of these requirements triggered new vendor coordination, material sourcing, and compliance verification steps that were not part of the original sample they approved.

The packaging spec they submitted was not unreasonable. It was standard for their industry. The problem was timing. When packaging requirements arrive after sample approval, the entire production timeline resets because packaging is not a post-production add-on. It is integrated into the manufacturing process at multiple stages.

Sterile pouch materials must be sourced from certified suppliers who can provide material compliance certificates. These certificates require 5-7 days to obtain and verify[^4]. Heat-seal parameters must be tested and documented to ensure sterile barrier integrity, which typically requires 3-5 test runs before final approval[^5]. Certification label printing requires artwork approval, barcode verification, and print quality testing, adding another 4-6 days.

When buyers ask why we cannot just wrap finished equipment in their specified packaging at the end of production, they are missing the quality control integration points. Packaging integrity testing happens during production, not after. If a sterile pouch seal fails integrity testing in week three of production, we must halt the entire run, adjust seal parameters, and restart with new test samples. This is why packaging specs must be locked before production starts, not submitted as an afterthought.

The Hidden Cost Structure of Medical Packaging

Packaging compliance cost often exceeds 20% of unit cost for orders under 100 units[^6]. This percentage shocks buyers who are accustomed to industrial packaging that typically represents 3-5% of total product cost. The difference is not markup. It is structural cost driven by certification requirements and low-volume production runs.

A standard industrial carton costs approximately $2-3 per unit at volumes above 500 units. The equivalent medical-grade packaging system with sterile pouches, certification labels, and tamper-evident features costs $15-25 per unit at volumes below 100 units[^7]. This cost gap is not negotiable. It reflects the fixed setup costs distributed across smaller unit counts.

Buyers who evaluate MOQ by comparing only machine prices are seeing an incomplete cost picture. When a 50-unit order gets quoted at higher per-unit cost than a 200-unit order, the price difference is often driven by packaging compliance overhead, not production efficiency gains.

Why Does "Lead Time from Order to Delivery" Mean Different Things to Buyers and Suppliers?

The phrase "four-week lead time" appears straightforward in a quotation. Buyers interpret it as the calendar gap between purchase order issuance and equipment arrival at their facility. Suppliers interpret it as production time after all specifications are locked and approved. This interpretation gap creates the most common project delays in medical equipment procurement.

Supplier lead time starts after sample approval and packaging specification confirmation, not when the purchase order is issued. First-time medical buyers often skip or underestimate the pre-production approval cycle, which can add 2-4 weeks before the quoted lead time clock actually starts counting.

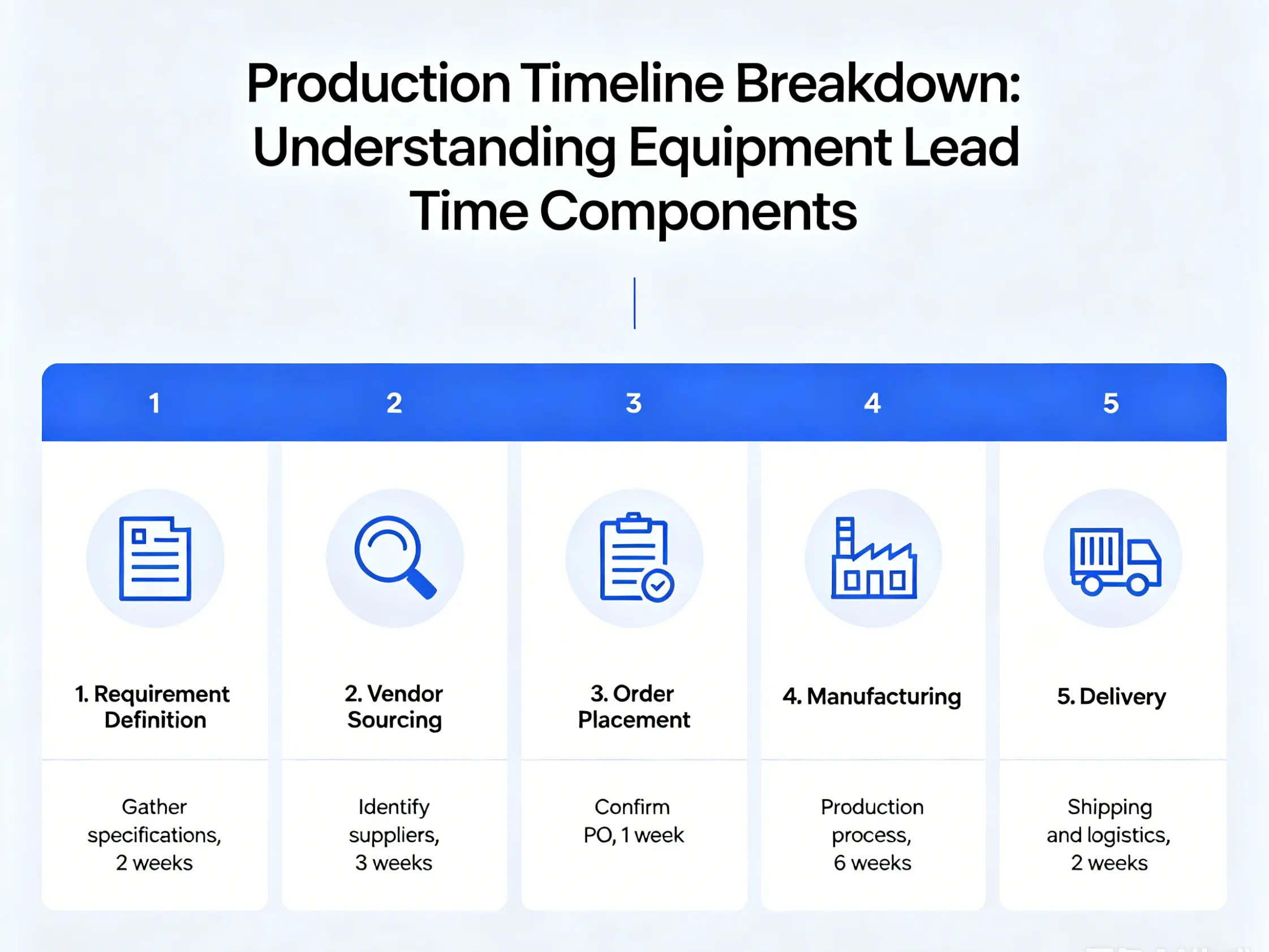

Production timeline breakdown

What Happens Between Purchase Order and Production Start

When we receive a purchase order, we immediately begin vendor coordination for certified materials, packaging components, and quality control documentation. This preparation phase is not counted in the quoted lead time because it assumes you have already completed sample approval and locked all specifications.

If your purchase order arrives with notes like "packaging details to follow" or "final blade configuration pending," the lead time counter does not start. We cannot order sterile packaging materials without exact dimensions and sealing specifications. We cannot source certified cutting components without finalized blade configurations and material compatibility requirements.

The pre-production approval cycle involves several sequential steps that cannot be parallelized. Sample approval must come before packaging design. Packaging design must be approved before material ordering. Material ordering must be completed before production scheduling. Each step has inherent waiting periods driven by vendor lead times and approval processes on both sides.

A medical packaging manufacturer recently submitted a purchase order with an urgent delivery request. They needed equipment in six weeks for a production line expansion. Their purchase order included approved equipment specifications but noted that packaging requirements would be submitted after their compliance team reviewed certification standards. This sequencing guaranteed a missed deadline because packaging approval alone would consume 2-3 weeks, leaving insufficient time for production even if we compressed all other steps.

The Compounding Effect of Specification Changes

Specification changes after production starts do not just add time. They multiply it. A blade configuration change in week two of a four-week production cycle does not add two weeks. It typically adds four to six weeks[^8] because it triggers new material sourcing, revised quality control protocols, and often requires restarting the entire production batch to maintain quality consistency.

When buyers request specification changes during production, they are essentially asking us to run two different production jobs with a single setup cycle. This is physically impossible in cleanroom environments where material handling protocols and quality control systems are configured for specific specifications.

Change Type If Made Before Production If Made During Production Why the Difference
Blade configuration 3-5 days for new material sourcing 15-20 days including batch restart Quality control protocol reset required[^9]
Packaging specification 7-10 days for vendor coordination 20-25 days including re-sampling Sterile packaging cannot be partially changed[^10]
Certification requirements 5-7 days for documentation review 30+ days including re-certification Batch-level traceability must be consistent
Material compatibility 4-6 days for testing 25-30 days including validation restart Testing cannot be performed on mixed batches

Experienced procurement teams lock all specifications before issuing purchase orders. They understand that specification flexibility after production start is not a service level issue. It is a physical impossibility when working with medical-grade production constraints.

Some buyers try to preserve flexibility by requesting partial shipments as specifications are finalized. This approach usually increases costs rather than reducing risk because each partial shipment requires separate packaging, certification documentation, and quality control cycles. The administrative overhead often exceeds any benefit from staged delivery.

How Do These Three Parameters Actually Interact on the Production Floor?

When you reduce MOQ below recommended levels, you are not just increasing per-unit cost. You are compressing the time buffer available for quality control iterations. Lower unit counts leave less margin for packaging test failures or certification documentation revisions. This compression increases the probability of lead time extensions because any quality control issue forces a complete batch restart rather than absorbing corrections within existing production volume.

Changing packaging specifications after locking MOQ triggers a cascade effect where minimum order quantities may no longer be economically viable under new packaging cost structures, and lead times must be recalculated to accommodate new vendor coordination and sampling cycles.

Think of MOQ, lead time, and packaging as three corners of a triangle. Moving any single corner forces the other two to adjust positions. Buyers who try to optimize one parameter in isolation often discover they have inadvertently degraded the other two beyond acceptable thresholds.

Real Scenarios Where Parameter Interaction Creates Timeline Gaps

A surgical equipment manufacturer once requested a 75-unit order with custom sterile packaging and a six-week delivery timeline. The MOQ we quoted was 100 units based on standard packaging cost structures. They negotiated down to 75 units without realizing that lower volume made custom packaging setup cost unsustainable within their target per-unit pricing.

We could have proceeded with their revised quantity, but only by increasing per-unit cost by approximately 30% to cover packaging setup overhead. They declined the price adjustment. We then proposed returning to 100-unit MOQ with their custom packaging, which brought per-unit cost back to target levels but extended lead time to nine weeks because custom packaging vendor required longer setup cycles for certification-compliant materials.

The buyer interpreted this as inflexible supplier response. What actually happened was a mathematical constraint where their preferred combination of MOQ, packaging specification, and lead time was physically impossible to achieve within their budget parameters. One variable had to give.

This type of parameter interaction happens repeatedly in medical equipment procurement because buyers optimize for one priority without understanding how that optimization constrains other variables. Procurement teams focused on minimizing MOQ to reduce inventory risk often discover that lower quantities make custom packaging economically nonviable, which forces them to either accept standard packaging or extend lead times to find lower-cost packaging vendors.

What Should You Lock Before Requesting a Final Quote?

Experienced buyers separate the inquiry phase from the quotation phase. During inquiry, they explore parameter ranges and understand constraint interactions. During quotation, they provide locked specifications that allow suppliers to commit to firm timelines and pricing.

The specifications that must be locked before a final quote can be issued include equipment configuration, blade specifications, material compatibility requirements, packaging design with exact dimensions and sealing specifications, certification requirements with specific standards and testing protocols, and delivery location with any special handling requirements.

When any of these specifications remains open during quotation, the quoted lead time and pricing must include contingency buffers that make the quote less competitive than it could be with locked specifications. Suppliers cannot commit to tight timelines when specifications might change after production starts.

Some buyers request quotes with notation like "packaging details to be confirmed later" or "certification requirements pending review." These notations signal to suppliers that the quoted lead time is preliminary and will likely be revised once specifications are finalized. Buyers who need firm commitments for project planning purposes must invest time upfront to lock specifications before requesting quotes.

Conclusion

Medical equipment MOQ, lead time, and packaging form a production constraint system, not a negotiable price list. Understanding their interaction prevents the timeline gaps and cost surprises that derail medical manufacturing projects before they start.


[^1]: "Recognized Consensus Standards: Medical Devices - FDA", https://www.accessdata.fda.gov/scripts/cdrh/cfdocs/cfStandards/detail.cfm?standard__identification_no=44738. FDA regulations and ISO 13485 standards establish environmental control requirements for medical device manufacturing, including cleanroom classifications and material handling protocols, though specific requirements vary by device classification and intended use. Evidence role: general_support; source type: government. Supports: that medical device manufacturing requires controlled environments and certified handling protocols. Scope note: Regulatory requirements vary by device classification, jurisdiction, and risk level [^2]: "21 CFR Part 821 -- Medical Device Tracking Requirements", https://www.ecfr.gov/current/title-21/chapter-I/subchapter-H/part-821. FDA regulations under 21 CFR Part 820 require device history records that establish traceability for each batch or unit produced, including material sources, manufacturing processes, and quality control data, as part of the Quality System Regulation for medical devices. Evidence role: general_support; source type: government. Supports: that medical device manufacturers must maintain batch-level traceability documentation. [^3]: "Quality System Regulation Labeling Requirements - FDA", https://www.fda.gov/medical-devices/device-labeling/quality-system-regulation-labeling-requirements. ISO 11607 establishes requirements for packaging systems used with medical devices that are terminally sterilized, including specifications for sterile barrier systems, seal integrity, and package integrity testing, though specific features depend on device classification and sterilization method. Evidence role: general_support; source type: institution. Supports: that medical device packaging must meet specific standards for sterility maintenance and integrity. Scope note: Requirements vary by device classification, sterilization method, and regulatory jurisdiction [^4]: "General Use Products: Certification and Testing | CPSC.gov", https://www.cpsc.gov/Business--Manufacturing/Testing-Certification/General-Use-Products-Certification-and-Testing. Medical device supply chain management studies document that material qualification and certification verification involve multiple steps including supplier documentation review, certificate validation, and traceability record creation, which constitute lead time factors in production planning. Evidence role: general_support; source type: research. Supports: that material certification and verification processes add time to medical device production schedules. Scope note: Actual processing times vary by supplier, material type, certification requirements, and existing supplier qualification status [^5]: "Recognized Consensus Standards: Medical Devices - FDA", https://www.accessdata.fda.gov/scripts/cdrh/cfdocs/cfstandards/detail.cfm?standard__identification_no=44773. ISO 11607-2 specifies validation requirements for packaging processes including seal integrity testing, though it does not prescribe specific numbers of test runs, instead requiring that validation protocols demonstrate process capability and reproducibility according to documented procedures. Evidence role: general_support; source type: institution. Supports: that sterile barrier seal integrity requires validation testing before production. Scope note: Specific validation protocols and test quantities depend on risk assessment, process complexity, and manufacturer's quality system [^6]: "Analysis of processes and costs of alternative packaging options of ...", https://pmc.ncbi.nlm.nih.gov/articles/PMC6734388/. Manufacturing cost analyses indicate that packaging and sterilization can represent substantial portions of total production costs for medical devices, with the percentage increasing significantly at lower production volumes due to fixed setup costs and regulatory compliance requirements. Evidence role: general_support; source type: research. Supports: that packaging represents a significant cost component in medical device manufacturing, particularly for small production runs. Scope note: Actual percentages vary widely by device type, packaging complexity, sterilization method, and production volume [^7]: "Analysis of processes and costs of alternative packaging options of ...", https://pmc.ncbi.nlm.nih.gov/articles/PMC6734388/. Industry cost analyses demonstrate that sterile medical device packaging involves substantially higher material and processing costs than standard industrial packaging due to regulatory requirements, sterile barrier materials, validation testing, and compliance documentation. Evidence role: general_support; source type: research. Supports: that medical-grade packaging systems cost significantly more than standard industrial packaging. Scope note: Specific cost figures vary by packaging configuration, volume, materials, sterilization method, and supplier [^8]: "[PDF] Deciding When to Submit a 510(k) for a Change to an Existing Device", https://www.fda.gov/media/99812/download. Manufacturing case studies document that specification changes after production initiation require material re-sourcing, process revalidation, quality control protocol updates, and often batch restarts, creating timeline impacts that substantially exceed the nominal change implementation time. Evidence role: general_support; source type: research. Supports: that specification changes during production create substantial timeline extensions due to cascading effects. Scope note: Specific timeline impacts depend on change complexity, production stage, supply chain factors, and regulatory requirements [^9]: "21 CFR Part 820 -- Quality Management System Regulation - eCFR", https://www.ecfr.gov/current/title-21/chapter-I/subchapter-H/part-820. FDA Quality System Regulation (21 CFR Part 820) requires that changes to device specifications, manufacturing processes, or materials undergo change control procedures including risk assessment, validation, and documentation updates to ensure continued compliance with design specifications and regulatory requirements. Evidence role: general_support; source type: government. Supports: that changes to medical device specifications require quality system updates and validation. [^10]: "ISO 11607 - Recognized Consensus Standards: Medical Devices", https://www.accessdata.fda.gov/scripts/cdrh/cfdocs/cfstandards/detail.cfm?standard__identification_no=44769. ISO 11607 requires validation of the complete packaging system as an integrated unit, including materials, sealing processes, and sterilization compatibility, because changes to any component can affect sterile barrier integrity and require revalidation of the entire system to demonstrate continued performance. Evidence role: mechanism; source type: institution. Supports: that sterile packaging systems require complete validation as integrated systems.

Factory Direct Supply

Need API, Dyes, or Fragrances?

BuyChemCN connects you directly with verified Chinese chemical factories -- no middlemen, competitive pricing, and small-batch orders welcome. Submit your inquiry and receive a factory-direct quote within 24 hours.

On-site Verified

All suppliers inspected

Tripartite Contract

Secure transactions

Small Batches OK

Flexible MOQ

24h Response

Fast quote turnaround
